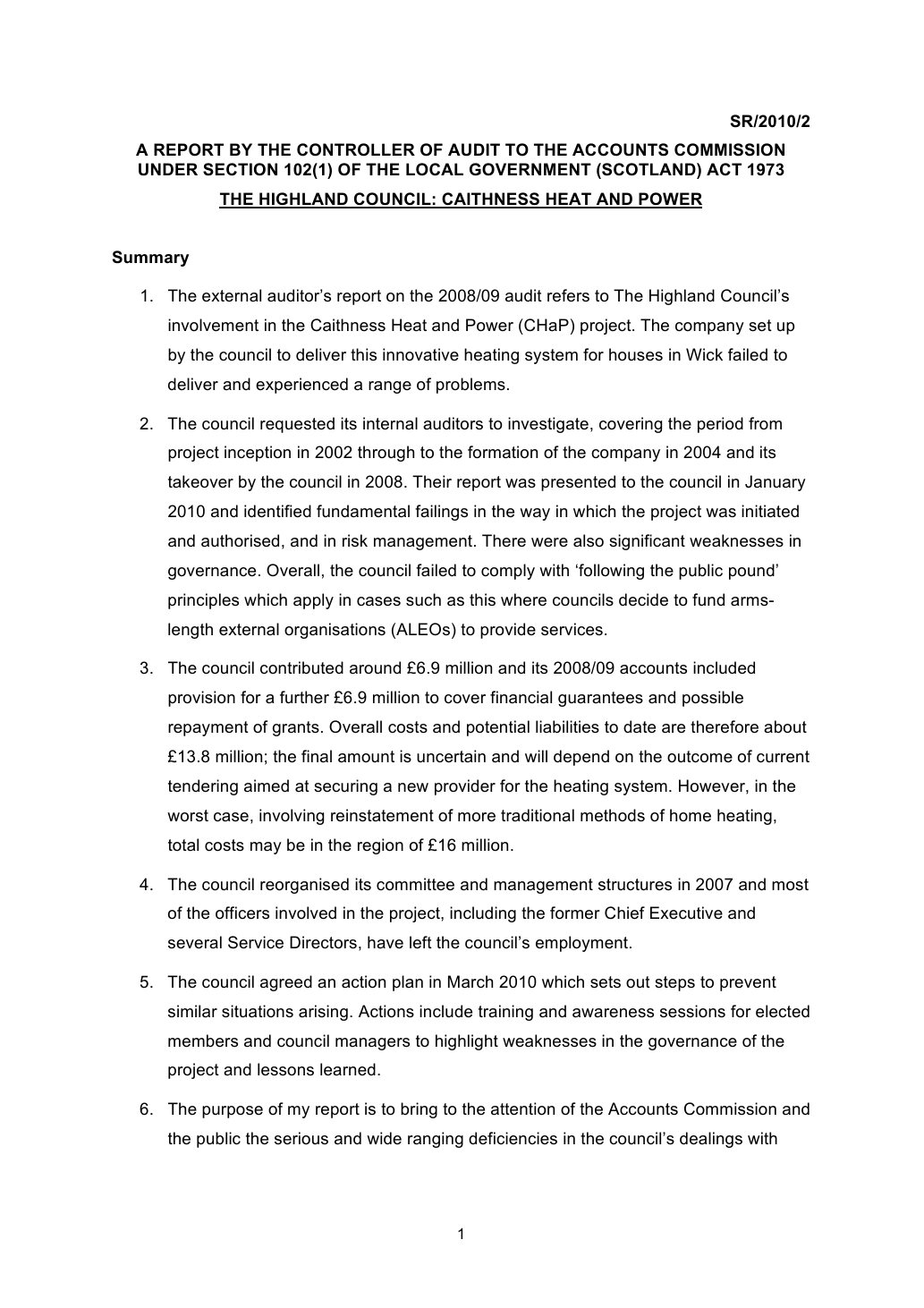

[Page 1]

SR/2010/2
      A REPORT BY THE CONTROLLER OF AUDIT TO THE ACCOUNTS COMMISSION
      UNDE R SECTION 102(1) OF THE LOCAL GOVERNMENT (SCOTLAND) ACT 1973
                            THE HIGHLAND COUNCIL: CAITHNESS HEAT AND POWER

Summary

       1.	                                            The external auditor’s report on the 2008/09 audit      refers to  The Highland Council’s
              involvement in  the Caithness Heat and Power (CHaP)     project. The company set up
              by the  council to deliver this innovative  heating  system  for houses in Wick failed to
              deliver and experienced a range of problems          .

       2.	                                             The council requested its internal auditors to investigate, covering the period from
              project  inception in 2002  through to the formation of the company in 2004 and    its
              takeover by the  council in 2008. Their report was presented to the  council in January
              2010 and identified     fundamental failings in the way in which the project was   initiated
              and authorised, and in risk management. There were also            significant weaknesses in
              governance  . Overall, the  council failed to comply with ‘following the public pound’
              principles  which apply in cases such as this where councils decide to fund arms                                   -
              length external organisations     (ALEOs) to provide services.

       3.	                                            The council contributed around £6.9 million and its   2008/09 accounts included
              provision for a fur   ther £6.9 million to cover financial guarantees and possible
              repayment of grants. Overall costs  and potential liabilities     to date are therefore about
              £13.8 million;                                              the final amount is uncertain and will depend on the outcome    of current
              tendering aimed at  securing a new provider for the heating system. However  , in the
              worst case, involving reinstatement of more traditional methods of home heating   ,
              total costs may be in the region of £16 million.

       4.	                                            The counc il reorganised its committee and management s tructures in 2007 and most
              of the officers involved in the project, including the former Chief Executive and
              several Service Directors, have   left the  council’s employment.

       5.	                                            The council agreed an action plan in March 2010                                                which sets out steps to prevent
              similar situations arising. A                       ctions include training and awareness sessions for elected
              members and  council managers to highlight weaknesses in the  governance of the
              project and   lessons learned.

       6.	                                            The purpose of my report is to bring to the attention of the Accounts Commission and
              the public the serious and wide ranging deficiencies in the   council’s                                                                                                                                                                                                                                                                                                            dealings with

                                                                                          1

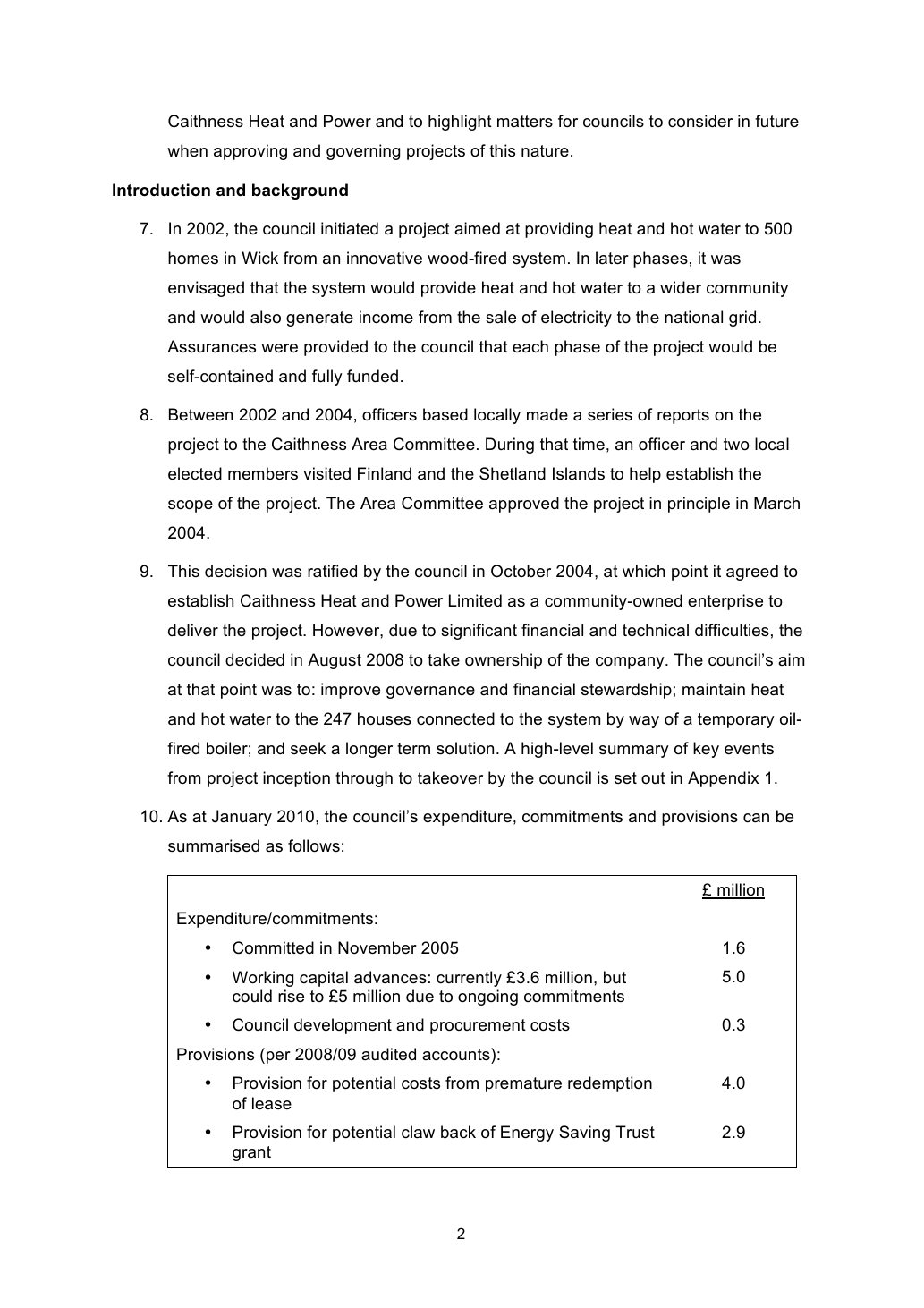

[Page 2]

Caithness Heat and Power   and to highlight matters for councils to consider in future
                   when approving and governing projects of this nature.

Introduction and background

         7.	       In 2002, the  council initiated a project  aimed at providing heat and hot water to 500
                   homes in Wick from an innovative      wood-fired system. In later phases, it was
                   envisaged that the system would provide heat and hot water to a wider community
                   and would also generate income from the sale of electricity            to the national grid.
                   Assurances were provided to the   council that each phase of the project   would be
                   self-contained and fully funded.

         8.	       Between 2002 and 2004, officers based locally    made a series of reports on the
                   project to the Caithness Area Committee. During that time, an officer            and two local
                   elected members visited Finland and the Shetland Islands to help establish the
                   scope of the project.   The Area Committee approved the project in principle in March
                   2004.

         9.	       This decision  was ratified by the   council in October 2004, at which point it a greed to
                   establish Caithness Heat and Power Limited as a community           -owned enterprise to
                   deliver the project.                         However, due to   significant financial and technical difficulties   , the
                   council decided  in August 2008 to take ownership of the company. The   council’s aim
                   at that point    was to: improve governance and financial stewardship; maintain he at
                   and hot water to    the 247 houses connected to the system by way of a temporary oil   -
                   fired boiler; and seek a longer term solution.   A high-level summary of key events
                   from project inception through to takeover by the   council is set out in Appendix  1.

         10. As at January 2010, the   council’s expenditure, commitments and provisions        can be
                   summarised as follows:

                                                                                                                                                                                                         £ million
                     Expenditure/commitments:
                               •        Committed in November 2005                                                                                                                                                                                                            	  1.6
                               •	       Working capital advances: currently £3.6 million, but                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                       5.0
                                        could rise t                                                               o £5 million due to ongoing commitments
                               •	       Council development and procurement costs                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                              0.3
                     Provisions (per 2008/09 audited accounts)                                                                                                                                                                                                                                                                                                                                           :
                               •	       Provision for                     potential  costs from premature redemption                                                                                                                                                                                                                                                                                                                                                                                 4.0
                                        of lease
                               •	       Provision for                     potential  claw back                               of Energy Saving Trust                                                                                                                                                                                                                  2.9
                                        grant

                                                                                                                     2

[Page 3]

___

                 Overall actual and potential cost                                                                                                                                                                                                                                                                                                                    s  13.8

       11. Potential future costs are uncertain until decisions on next steps   are taken,                                            and will
              depend on whether the      council can secure a new provider for the heating system.
              Following a tendering exercise the      council is currently negotiating with two
              companies that have expressed an interest in taking over the project. If these
              negotiations are not successful the        council estimates that in the worst case, involv      ing
              reinstatement of conventional heating systems in the properties, the total costs over
              the lifetime of the project could be of the order of £16 million.

       12. The council’s internal auditors reviewed the governance of the project from its
              inception through to the time at which the      council took control of the company.  The
              external auditors have reviewed internal audit’s work and have informed me that in
              their opinion the scope of the internal audit investigation  , the audit approach and the
              conclusions are appropriate. They have also informe                     d me that in their opinion the
              council’s action plan reflects the key improvements required         . I relied on the                      se audit
              findings to highlight key issues  in this report and provided a copy of      the report to the
              council’s Chief Executive for comment.

There were f undamental failings in project     initiation and  authorisation, and in project
risk management

       13. The internal auditors’ investigation identified a  range of issues arising from project
              initiation  and approval. In particular     , they found :

              •	         Given its size and nature, it was inappropriate for the Area Committee to
                         consider the project and to  approve it in principle. Eight reports were
                         considered between August 2002 and August 2004         . Despite the potential  costs
                         and the risks associated with the use of new technology, these reports were
                         made without recourse to  a Headquarters Committee (specifically the
                         Resources Committee  within whose remit matters of this nature f  ell, in  terms of
                         the council’s Scheme of Delegation ).

              •	         In relation to the  locally based  officer who initiated the project     , internal audit
                         questioned whether the officer had        the appropriate qualifications and skills to
                         take forward a project of this nature  .

              •	         Although the elected member and officer visits to Finland and the Shetland
                         Islands to inspect district heating systems                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                                               were intended to                                  inform decision

                                                                                           3

[Page 4]

making, it is not evident that the visits were of relevance. Furthermore,     internal
                 audit questioned whether the elected members          and officer in attendance
                 possessed the appropriate skills      and qualifications.

          •	     In terms of the  council’s Scheme of Delegation it was inappropriate for the
                 project to have been initiated and progressed by the Planning & Development
                 Service when the remi t lay with Property & Architectural Services, wh  ich had
                 the technical expertise and authority to investigate and recommend projects of
                 this nature. There is evidence that the  most senior officer in Property &
                 Architectural Services expressed concerns   about  the project to senior officer
                 colleagues outwith his department     in advance of the  council’s approval, but it
                 appears no effective action was taken       .

          •	     The momentum  and expectation of delivery at       area level led to the application
                 for external grant funding from the Energy Saving Trust. This was submitted by
                 locally based officers without recourse to  council headquarters and contained
                 inaccuracies. The announcement in September 2004 of grant funding of £1.54
                 million  and the p                                                                erceived benefits    for the Caithness  area was made prior to the
                 council’s approval of the project      in October 2004.

          •	     The council approved the project without establishing whether it had been
                 subject to a formal project   and risk appraisal or     if a sound business case
                 existed.

          •	     The council approved the establishment of C                                              HaP Limited without receiving
                 proper assurances regarding the project and without key documentation being
                 in place. In particular, there was no formal project appraisal  , business plan   or
                 risk management plan, nor was there any detail of                                 the proposed remit,
                 structure, resourcing and governance of the    company .

     14. In relation to risk management, the   internal auditors concluded that inadequate
          consideration was given to the vari  ous risks (technical, financial, business and legal)
          associated with   the project, both at the outset and during the project’s life. When
          risks were identified these were largely dismissed and were not formally recorded
          and managed. In addition, the measure        s to mitigate any risks were insufficiently
          considered, were inappropriate or were disregarded.   Internal audit concluded that
          there was a drive to push ahead  by certain officers   irrespective of the risks  identified.

                                                               4

[Page 5]

There were  also signi ficant weaknesses in governance

       15. The internal audit ors identified significant weaknesses in the governance of            the
              project.  In particular, they found:

              •	         It was not evident to internal audit that the    council’s elected member on the
                         CHaP Board had the appropriate skil   ls or had received appropriate training to
                         fulfil the role effectively.

              •	         The council acknowledged the need to strengthen the governance
                         arrangements, before the project commenced and throughout              its life, but no
                         meaningful progress was made.   Governance was exercised on an ad-                                                hoc
                         basis and with no clarity as to how and by whom any resultant actions would be
                         addressed.

              •	         Despite initial assur ances  from a locally based officer to the Area Committee
                         that the  company would employ professional managers, th                             is did not happen  to
                         the extent envisaged and the                                                                                                     council provided a considerable resource and
                         effectively took on the role of      professional managers.

              •	         Governance of the project was weakened by a lack of communication between
                         Area and Headquarters  staff. In particular, and at critical    times before the
                         project was agreed by the      council and over the duration of the project         ,
                         Headquarters was  not made aware of important issues and developments.

              •	         Despite the risks  inherent in an innovative project, following the project’s
                         approval in October 2004 reporting to the          council  was infrequent and only took
                         place when the    company was urgently seeking funds.        Reports also provided
                         assurance that the project was on track when this was not the case.              When key
                         decisions were   made by the company, in particular                        to move beyond the initial
                         phase  to include electricity generation and to merge the distinct phases of the
                         project , despite the  ir significance these were not brought to the attention of the
                         council.

              •	         Prior to the  council approving the project,      council officers worked with the
                         proposed   company’s prospective external legal and technical advisors ,
                         effectively engaging them prior to the         company’s incorporation. As a
                         consequence, the  council’s Contract Standing Orders were  breached  .

              •	         Although a form of due diligence was undertaken    by the company before it
                         awarded  the gasification tender (which extended the project to include
                         electricity generation)     in April 2006, the risks hi ghlighted were not adequately

                                                                                        5

[Page 6]

considered by the officers involved in the project locally, or the      council-
                  nominated Member on the CHaP Board. Furthermore, these risks were not
                  made known to the   council  when it would have been appropriate    to do so given
                  their significance. Ultimately the project failed because the    company procured
                  ‘experimental’ and high risk gasification technology which  could not be
                  commissioned successfully.    In awarding the contract   , the CHaP Board decided
                  to procure a system which had no clear history of success elsewhere.

          •	                                                                           Although the evaluation  of the gasification tenders by the company                                  was
                  overseen  by its external technical advisor, of considerable concern is that the
                  advertised evaluation criteria, including the need to demonstrate proven
                  capability, were disregarded. Instead, price and potential output became the
                  key drivers.  The company’s failure to adhere to its advertised criteria
                  represents a  breach of  the procurement legislation which could have exposed        it
                  to legal challenge.

     16. Internal audit w as of the opinion that the Joint Ventures Board of senior officers    was
          an appropriate forum for governing the project. Although the                                              board  considered the
          project in its early stages, until June 2005, the project was not on               the agenda for
          subsequent meetings. Internal audit has not been able to establish why that was the
          case.

     17. In relation to the statutory officers, who have specific powers and responsibilities as
          set out in the local government legislation,   internal audit suggested that the    council’s
          officers should have exercised greater influence, to varying degrees, on the
          governance of the project      through the application of their statutory roles  .

The counc il did not                         comply with ‘f                     ollowing the   public  pound’ principles

     18. Councils fund arms -length external organisations (ALEOs) as alternative way s of
          providing vital services and     securing social benefits.   To ensure that public money is
          used properly and achieves value for money, it must be possible to ‘ follow the public
          pound’ across organisational boundaries and to establish and maintain good
          governance and clear accountabilities for finance and performance. The Accounts
          Commission/COSLA Code 1 sets out the principles of best practice when councils
          establish s ignificant funding arrangements with ALEOs, covering crucial areas such
          as financial and performance monitoring, representation on the boards of ALEOs and
          establishing limits on the degree of involvement.

1    The Code of Guidance on Funding External Bodies and Following the Public Pound, Accounts
Commission/Convention of Scottish Local Authorities 1996

                                                               6

[Page 7]

19. Internal audit   ’s findings on CHaP point to a range of areas where the          council did not
             comply with the Code’s requirements. As a consequence , officers were not clearly
             aware of their responsibilities and relevant monitoring procedures. Where specific
             responsibilities were assigned, including maint aining a watching brief to represent
             the council’s interests, there is little evidence to suggest these roles were delivered
             effectively.

      20. The internal audit report  highlighted   the potential for  conflict of interest  arising from a
             lack of appropriate separation between the responsibilities of  council officers and   the
             advisors to  the company. For example, a locally based      council officer became
             involved in the financial affairs of the company and was appointed Company
             Treasurer.

Action taken by the   council

      21. The current Chief Executive and Depute Chief Executive & Director of Finance
             reported to the  council on five occasions between     May 2008 and February 2009,
             informing it about  technical, financial and governance problems in the company and
             the findings of an operational team of officers set up to support the project. I                                                                   n
             February 2009, they provided an update on    the action taken   since the council   took
             over the company in August 2008        to improve governance and financial stewardship,
             maintain heat and hot water to tenants and to seek a long term solution. The report
             also stated that internal audit would undertake an audit of the project.

      22. The council considered the internal audit report at a special meeting in J     anuary 2010
             and agreed to the actions set out in the report           including compulsory training for all
             elected members appointed by the        council to act as company director . The                      council
             also agreed to inform the external auditors and the Scottish            Government of
             developments.

      23. In March 2010, the  council approved an action p    lan detailing a range of actions
             aimed at preventing similar situations arising along with           target dates and the officers
             responsible. Steps include: training and awareness sessions for elected members
             and council managers to highlight weaknesses in governance of the CHaP project
             and to share the lessons learned; and exploring the possibility of legal action against
             individuals and others connected with the company. T  here is also an action for an
             independent review  of the possibility of a  disciplinary investigation to consider
             whether those officers still employed by the council                                   failed to perform their duties in a
             professional and competent manner.        All actions are to be addressed by 30

                                                                                  7

[Page 8]

September 2010 and this timetable will allow the external auditors to assess and
          comment on progress in  their report on the 2009/10 audit in October 2010.

Overall conclusions

     24. The purpose of my report is to bring to the attention     of the Accounts Commission and
          the public the serious and wide ranging deficiencies in the Council’s dealings with
          Caithness Heat and Power  . The internal and external audit reports point to serious
          weaknesses in governance and accountability   and, in partic ular, failure to comply
          with the ‘following the   public pound’ principles.

     25. I note that t he council has responded to the serious concerns  in the internal audit
          report and that officers have   implemented and continue to    implement remedial action
          for which they are accountable to elected members.  I am informed                        that most officers
          involved in the project  have left the   council and I am content to allow    those thought to
          be responsible and still employed by the    council to be held to account th    rough any
          investigatory and disciplinary process    which it considers  appropriate  .

     26. The external auditors will                                assess the progress made and the effectiveness of revised
          arrangements as part of their planned audit work and             will report in the usual way. I
          will monitor the position and may report again in due course.

CAROLINE GARDNER
CONTROLLER OF AUDIT
7 June                                    2010

                                                              8

[Page 9]

APPENDIX 1

                                                                 THE HIGHLAND COUNCIL: CAITHNESS HEAT AND POWER
                                                                                                                                              SUMMARY OF  KEY EVENTS

                                August  2002                                                                                        Locally based                                                     council  officers  report to Caithness Area
                                                                                                                                    Committee  proposing Community Energy Initiative

                                2002 – 2004                                                                                         Project development, including site visits to help establish the

This is the opening portion of a long document. Use Download complete plain text above for the full extracted transcript.

Original publisher: https://www.audit-scotland.gov.uk/docs/local/2010/sr_100624_chaps.pdf
